Walk into any manufacturing facility mid-shift and you will see it everywhere: raw materials being cut, shaped, assembled, or treated. Products that are no longer just raw inputs, but not yet finished goods either. This in-between state — the goods partially transformed, the costs already committed, the value not yet realised — is what the manufacturing and finance world calls WIP.
WIP, or Work in Progress, sits at the intersection of production management, inventory accounting, and supply chain efficiency. Understanding it is not just a matter of completing a textbook definition — it directly shapes how a manufacturing business manages cash flow, measures productivity, and competes on delivery speed.
This guide covers everything you need: the full form and plain-language meaning of WIP, how it differs from work in process, the formula and a worked calculation example, how to calculate work in progress days, and the most practical strategies to reduce excess WIP in your manufacturing environment.
WIP Full Form and Meaning
WIP stands for Work in Progress (also written as Work in Process — more on that distinction shortly). In a manufacturing context, it refers to any item that has begun the production process but has not yet been completed and made available for sale.
Think of WIP as the middle stage in a three-part inventory journey:
Stage | What It Is | Balance Sheet Treatment |
Raw Materials | Inputs purchased and waiting to enter production | Current asset — inventory |
Work in Progress (WIP) | Items partially transformed, currently in production | Current asset — inventory (WIP account) |
Finished Goods | Completed products ready for sale | Current asset — inventory (finished goods account) |
From an accounting perspective, WIP is recorded on the balance sheet as a current asset. This is because the costs embedded in WIP — raw materials consumed, labour applied, and manufacturing overhead absorbed — represent real capital that has been deployed. Once production is complete, the WIP balance moves into the finished goods account, and when those goods are sold, it flows into Cost of Goods Sold (COGS) on the income statement.
Work in Progress vs Work in Process — Is There a Difference?

This is one of the most commonly searched points of confusion around WIP — and one that most articles skip over.
Technically, work in progress and work in process are used interchangeably in most manufacturing and accounting contexts. Both abbreviate to WIP, and both appear on the balance sheet in the same way. However, there is a subtle conventional distinction worth knowing:
- Work in Process tends to be used in manufacturing and production accounting, particularly for goods with shorter production cycles — items being assembled, fabricated, or processed in a factory environment.
- Work in Progress is more commonly used in project-based industries — construction, engineering, software development — where a deliverable is being built over a longer timeline and percentage-of-completion accounting may apply.
When a manufacturing company uses either term, they mean the same thing: partially completed inventory that has incurred costs but not yet been converted into a finished, sellable product. For the purposes of this guide, WIP and work in progress are treated as equivalent.
What Does WIP Actually Include?
WIP is more than just half-built products sitting on the production floor. In accounting terms, WIP inventory captures three distinct cost components:
1. Raw Material Costs
The cost of raw materials that have been drawn from inventory and entered the production process. Once a material is issued from the warehouse to the production floor, it transitions from raw materials inventory into WIP.
2. Direct Labour Costs
The wages and associated costs of the workers actively applying their time to transform raw materials. Every hour of production labour spent on an unfinished item adds to its WIP value.
3. Manufacturing Overhead
The indirect costs that support production — machine depreciation, facility costs, utilities, production supervision, and tooling expenses. These are allocated to WIP based on standard costing methods or actual overhead rates.
The WIP Process: How an Item Moves Through Production

Understanding WIP in isolation is one thing. Seeing how it flows through a real production environment makes the concept tangible and reveals exactly where problems accumulate.

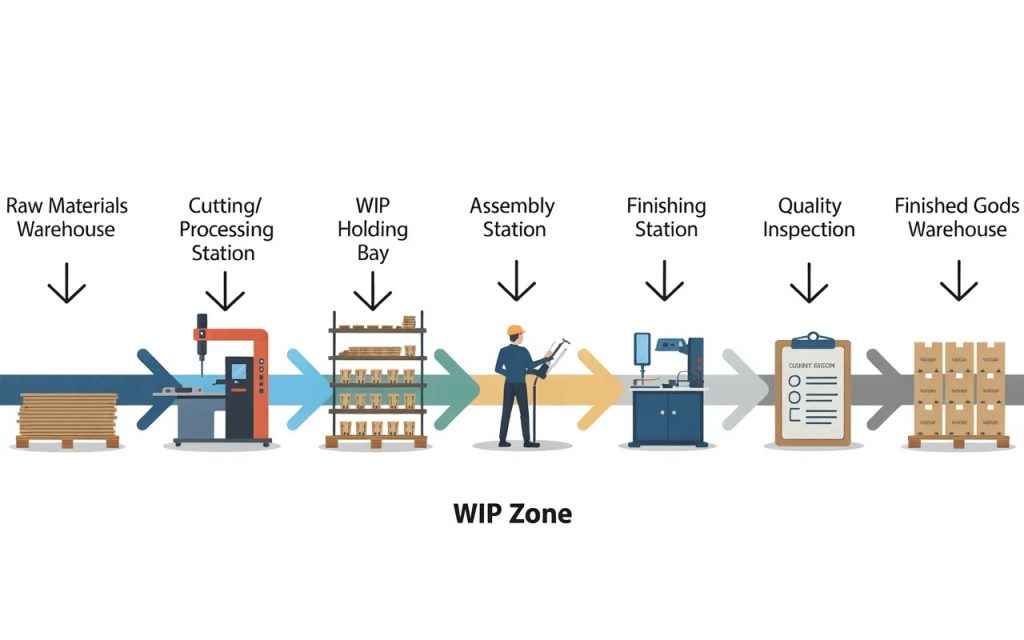

Consider a furniture manufacturer producing dining tables. Here is how WIP moves through their facility:
- Raw timber and hardware components are issued from the warehouse to the cutting station. At this point, they enter WIP.
- The cutting station shapes the timber into table legs and tabletop panels. These pieces move to the assembly WIP bay.
- The assembly team joins the legs to the frame. The partially assembled table moves to the finishing station.
- The finishing team sands, stains, and lacquers the table. It moves to quality inspection.
- Once it passes inspection, it transfers out of WIP and into finished goods inventory, ready for dispatch.
At every stage between the raw material issue and the quality sign-off, this table is WIP. Every cost incurred at each workstation — material, labour, machine time — is being accumulated into its WIP value. The faster it moves through each stage, the less time capital is locked in WIP and the faster it can be converted to revenue.
The WIP Formula — And How to Calculate It
WIP inventory is calculated at the end of an accounting period using a straightforward formula. It tells you how much value is sitting in partially completed goods at the close of your books.
Ending WIP Inventory = Beginning WIP Inventory + Total Manufacturing Costs − Cost of Goods Manufactured (COGM)
Breaking Down the Three Components
- Beginning WIP Inventory — the WIP balance carried forward from the previous accounting period. This is the closing WIP balance from your last financial report.
- Total Manufacturing Costs — the full cost of all manufacturing activity during the period: raw materials consumed, direct labour, and manufacturing overhead absorbed.
- Cost of Goods Manufactured (COGM) — the total cost assigned to all goods that were completed and transferred to finished goods inventory during the period.
Worked Example
A manufacturing company enters Q3 with the following figures:
- Beginning WIP Inventory: $40,000
- Total Manufacturing Costs incurred during Q3: $320,000
- Cost of Goods Manufactured (completed and moved to finished goods): $310,000
Ending WIP = $40,000 + $320,000 − $310,000 = $50,000
This means $50,000 worth of partially completed inventory is sitting in the production process at the end of Q3. This amount will carry forward as the Beginning WIP Inventory for Q4. The $10,000 increase from the beginning of the period signals that slightly more work entered production than was completed — which may indicate a growing backlog or a bottleneck worth investigating.
Work in Progress Days — The KPI Most Manufacturers Overlook

Worked Example
- Average WIP = ($40,000 + $50,000) ÷ 2 = $45,000
- COGM for the quarter = $310,000
- Days in period = 91 (Q3)
What is a WIP Meeting?
In both manufacturing and project management, a WIP meeting (Work in Progress meeting) is a regular operational review where teams assess the current status of in-progress work. In a manufacturing context, this typically involves production supervisors, planning teams, and supply chain managers reviewing:
- Which production orders are currently in WIP and at what stage
- Whether any items are stalled or exceeding expected cycle times
- Whether bottlenecks are building at specific workstations
- Whether materials or resources need to be reallocated to maintain flow
In project management environments — construction, software, creative agencies — WIP meetings serve a similar purpose: reviewing ongoing tasks, identifying blockers, and ensuring work is progressing toward completion on schedule.
WIP meetings are a practical mechanism for keeping WIP levels visible, manageable, and under continuous improvement pressure. In lean manufacturing environments, they are often run as short daily stand-ups at the start of each shift.
The Real Cost of Too Much WIP
In lean manufacturing philosophy, excess WIP is classified as one of the seven wastes — specifically, the waste of overproduction. But the consequences of bloated WIP extend far beyond a theoretical framework. Here is what actually happens when WIP accumulates unchecked:
Capital Gets Frozen
Every unit of WIP represents money that has been spent but not yet converted to revenue. A manufacturer with $2 million in WIP has $2 million tied up in production that cannot pay salaries, service debt, or fund procurement. The longer WIP sits, the more pressure it puts on working capital and cash flow forecasting.
Quality Defects Multiply
Items sitting in WIP bays between production stages are exposed to handling damage, environmental degradation, and the risk of being worked on out of sequence. Research in lean production consistently shows that defect rates increase with WIP dwell time — particularly in industries where in-process items are temperature-sensitive, time-sensitive, or require precise handling.
Bottlenecks Become Invisible
When WIP is allowed to build up across the production floor without monitoring, the real bottlenecks in the process get masked. Excess buffer stock between stations hides the fact that one workstation is running at 60% of the throughput it needs to maintain flow. By the time the bottleneck is discovered, the backlog has compounded significantly.
Delivery Lead Times Suffer
High WIP directly translates to longer customer lead times. Little’s Law — one of the fundamental principles of production flow — states that Lead Time = WIP ÷ Throughput Rate. Double your WIP without changing throughput, and you have doubled your average lead time. In markets where delivery speed is a competitive differentiator, this is a direct threat to customer retention.

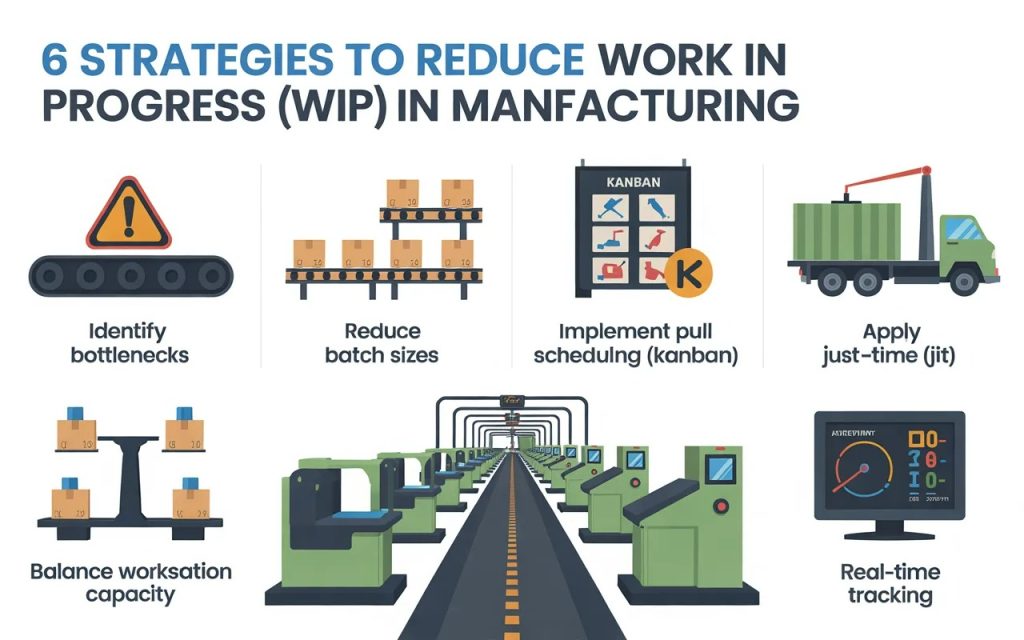

How to Minimise WIP in Manufacturing: 6 Practical Strategies

Reducing WIP is not about cutting production — it is about making production flow more smoothly so that items spend less time waiting and more time being actively worked on. These are the strategies that actually move the needle:
1. Map Your Production Flow and Find the Bottleneck
Before trying to reduce WIP, you need to know where it is building. Use value stream mapping to trace every step of the production process and identify where inventory is accumulating. In almost every case, WIP builds immediately upstream of a constrained resource or bottleneck workstation. Fixing the bottleneck — whether by adding capacity, redesigning the workflow, or redistributing labour — is the highest-leverage WIP reduction action available.
2. Reduce Batch Sizes
Large production batches create large WIP queues. When a workstation processes 200 units before passing them to the next station, those 200 units sit in WIP for the entire processing time. Reducing batch sizes — even if it means more frequent changeovers — dramatically reduces WIP dwell time and speeds up throughput. This is the principle behind one-piece flow in lean manufacturing.
3. Implement Pull Scheduling (Kanban)
Push scheduling — where production stages produce as much as they can regardless of downstream demand — is the fastest route to WIP explosion. Pull scheduling, implemented through Kanban systems, ensures that each production stage only works when the downstream stage signals it is ready to receive more. This synchronises the entire production line around actual capacity and demand, keeping WIP at the lowest viable level.
4. Apply JIT (Just-in-Time) Principles
JIT manufacturing aims to produce exactly what is needed, exactly when it is needed, in exactly the quantity required. It is the philosophical heart of WIP minimisation. In practice, this means aligning production schedules tightly to customer orders, reducing raw material buffer stocks, and designing production cells that can shift between products quickly. The result is a manufacturing environment where WIP is always in motion and rarely sitting still.
5. Match Workstation Capacity to Demand
One of the most common causes of WIP accumulation is a mismatch between the capacity of adjacent workstations. If Station A can process 150 units per hour and Station B can only handle 100, 50 units per hour will accumulate as WIP between them. Regularly reviewing and rebalancing workstation capacity — whether through operator reassignment, equipment upgrades, or process redesign — directly controls WIP levels.
6. Use Real-Time WIP Tracking Technology
Manual WIP tracking — clipboards, daily counts, end-of-shift reports — is always lagging. By the time a manager sees a WIP report, the situation on the floor has already changed. Real-time WIP tracking, enabled through barcode scanning, RFID, or MES (Manufacturing Execution Systems) integration, gives production managers live visibility into exactly where every unit is, how long it has been at each stage, and where the next problem is forming.
WIP and the Supply Chain: Why They Are Inseparable
WIP does not exist in isolation from the broader supply chain. In fact, the health of your WIP is often a direct reflection of the health of your supply chain upstream and downstream.
Unreliable supplier lead times force manufacturers to hold larger raw material buffers — which in turn creates pressure to run larger production batches — which inflates WIP. Similarly, unpredictable customer demand leads to speculative production, pushing items into WIP that may wait in finished goods longer than planned.
From a supply chain strategy perspective, the goal is to create end-to-end flow visibility — knowing exactly how much material is incoming, how much is in production, and how much is ready for dispatch, at every moment. This visibility is what allows supply chain managers to make confident decisions about production scheduling, procurement timing, and customer commitment dates.
This is precisely where integrated supply chain and WIP management platforms deliver their most significant value — not just by tracking WIP as a number, but by connecting WIP data to procurement signals, production schedules, and customer demand forecasts in a single operational view.
Technology for WIP Management: What to Look For

Spreadsheets and manual counts are no longer adequate for managing WIP in a modern manufacturing environment. The speed at which production conditions change — demand signals, material availability, machine downtime — demands systems that can respond in real time.
When evaluating technology solutions for WIP management, the capabilities that matter most are:
- Real-time shop floor visibility — live tracking of every production order’s location and stage
- Automated WIP costing — continuous calculation of WIP value as materials, labour, and overhead are posted
- Bottleneck alerts — automatic notification when WIP accumulates beyond defined thresholds at any workstation
- Integration with procurement — so that material shortages causing WIP delays are flagged before they impact production
- WIP reporting and KPI dashboards — WIP days, WIP turnover rate, and WIP by product line in a single view
- Integration with ERP and accounting systems — so that WIP values flow directly into financial reporting without manual reconciliation
Manufacturing companies across Singapore and Southeast Asia are increasingly adopting integrated ERP and WMS platforms that consolidate WIP tracking, inventory management, production planning, and financial reporting into a single system — eliminating the data lag that makes manual WIP management so difficult.
Final Thought
WIP is one of those concepts that seems simple on the surface — partially finished goods — but becomes increasingly significant the deeper you look. It is a real-time indicator of production health, a direct determinant of cash flow velocity, and a mirror that reflects everything going right or wrong in your manufacturing process.
The manufacturers who manage WIP best are not necessarily the ones with the most sophisticated equipment. They are the ones with the clearest visibility: they know exactly how much WIP they have, where it is, how long it has been there, and what it is costing them. That visibility — more than any single strategy or tool — is what separates a well-run production floor from a chaotic one.
FAQ
WIP stands for Work in Progress (also written as Work in Process). In manufacturing and accounting, it refers to partially completed goods that are currently in the production process — not yet finished and not yet available for sale.
In manufacturing, WIP refers to any material or product that has entered the production process but has not yet been completed. It includes the cost of raw materials consumed, direct labour applied, and manufacturing overhead absorbed at each production stage.
The WIP inventory formula is: Ending WIP = Beginning WIP Inventory + Total Manufacturing Costs − Cost of Goods Manufactured (COGM). It calculates the value of partially completed inventory at the close of an accounting period.
Work in progress days (WIP days) measures how long, on average, an item spends in the production process before becoming a finished good. Formula: WIP Days = (Average WIP Inventory ÷ Cost of Goods Manufactured) × Number of Days in Period. A rising WIP days trend signals declining production efficiency.
In practice, both terms mean the same thing and both abbreviate to WIP. Conventionally, ‘work in process’ is preferred in manufacturing accounting for goods with short production cycles, while ‘work in progress’ is used in project-based industries (construction, engineering) for longer-term deliverables. On the balance sheet, both are treated identically as current assets.
A WIP room or WIP bay is a designated holding area on the production floor where partially completed goods are staged between production stages. It acts as a buffer between workstations. A consistently full WIP room is typically a visual indicator of a bottleneck in the production process.
A WIP meeting is a regular operational review — often a short daily or weekly stand-up — where production supervisors, planners, and supply chain teams review the status of all in-progress work. The goal is to identify stalled items, resolve bottlenecks, and ensure production flow is on track.
